managed bvlos · flown for you

Your sites, flown for you — across the UK.

heliguy installs the dock, holds the approvals and flies your sites to an agreed schedule — from one command centre. You own the sites. We operate them under our authorisation.

Fly under our OAPer-site managed serviceInstalled · flown · maintainedNationwide from one ROCC
18 mo
of findings
dialogue with the CAA
5
AAE methodology
options iterated
13
documented
demonstration flights
1st
EC on a DJI airframe
with 24-bit ICAO
the shortcut past the barrier

You don’t need your own approval.

Standing up your own BVLOS operation means 18+ months of safety-case dialogue with the CAA, a specialist team, and six figures of cost — before a single flight. Or your sites fly under heliguy’s operational authorisation, from day one.

On your own
Build a safety case, hire the expertise, carry the approval — then recruit and roster BVLOS pilots.
With heliguy
Your sites operate under our OA, flown by our BVLOS pilots, to your schedule. You provide the sites; we bring everything else.
the managed service

Everything between the site and the data — handled.

A per-site service, not a product sale. You keep operating your business; the drone programme runs in the background as a service heliguy owns end to end.

01

Installation

Site survey, dock siting and power/comms — the DJI Dock 3 commissioned and connected.

02

Approvals

The BVLOS safety case and CAA authorisation for each site — written, argued and held by us.

03

Operations

Flights commanded remotely by our BVLOS pilots from the ROCC, to an agreed schedule.

04

Maintenance

Aircraft, dock and payload kept serviceable — DJI-authorised, UK-based, no downtime to manage.

05

Data

Inspection-grade imagery and outputs delivered to your teams, capture after capture.

You provide

The sites and the schedule.

Access to your locations and what you need flown, how often. That’s the extent of your operational burden.

heliguy provides

Everything else.

Hardware, authorisation, pilots, maintenance and the command centre — as one accountable managed service.

01 · why this approval matters

The UK BVLOS bottleneck, and what breaks it.

Drone-in-a-box only pays when the drone can fly the whole site. Under visual line of sight, every automated mission still needs eyes on the aircraft — a person on the ground, a chase vehicle, a cap on range. The economics of an autonomous dock collapse the moment you tether it to a human standing in a field.

SAIL II is what unlocks it. A Specific Assurance and Integrity Level II operation lets a docked aircraft fly Beyond Visual Line of Sight along a defined route — no on-site observer — provided the safety case proves containment, conspicuity and contingency to the CAA’s satisfaction. That proof is the entire barrier.

And over live rail is the hardest version of the problem. Moving trains, overhead line equipment, third parties on the network, controlled airspace overhead. If the argument holds here, it holds almost anywhere.

Approvals are not bought. They are argued — and here is the argument.

02 · the sora ladder

What each rung of SAIL actually demands.

SAIL — Specific Assurance and Integrity Level — grades how much rigour a Specific-category operation must prove. Move up the ladder to see how ground risk, air risk and the evidence burden change. heliguy’s approval sits at SAIL II.

SAIL II

heliguy · shielded BVLOS

Shielded BVLOS along a defined route with a docked aircraft. Low-to-moderate risk, but the containment and conspicuity argument must be genuinely proven — this is where heliguy’s rail approval sits.

Ground risk
Air risk
OSO burden
Realistic timescale12–18 months
Typical useDock-based BVLOS inspection of linear and industrial infrastructure — rail, energy, refineries.
heliguy’s DJI Dock 3 / M4TD rail approval
03 · the atypical air environment

Flying inside a space other aircraft can’t reach.

The core of a shielded BVLOS argument is the Atypical Air Environment — a volume close to structures where crewed aircraft do not, and should not, fly. Prove the drone stays inside it, and the air-risk problem changes shape. Here’s how the methodology evolved to the version that passed.

GROUND LEVELBUILDINGOLE · LINEAR INFRA100 ft50 ftM4TD
Option 1 — terrain-based
The first methodology derived the environment purely from terrain — the ground profile beneath the route. Simple to model, but it under-represents how obstacles and structures actually shape the volume a crewed aircraft would avoid.
04 · containment, layer by layer

Four layers between routine and runaway.

Containment is what convinces a regulator the aircraft cannot leave its volume — and what happens if every prior assumption fails. Peel it back from the outside in. Each layer was demonstrated, not asserted.

SOFT CONTAINMENTPREDICTABLE BEHAVIOURHARD CONTAINMENTFTS
01

Soft containment

Mission design keeps the aircraft well inside its volume before any system intervenes — geographic mission limits, an N-mode speed restriction to 7 m/s, and FlightHub 2 operational caps.
operating limits applied in FlightHub 2 and verified pre-flight
02

Predictable autonomous behaviour

The aircraft’s automated responses are deterministic and known in advance — the operator can state exactly what it will do at any point on the route, which is what lets the layers above it be trusted.
behaviour characterised across the route and documented
03

Hard containment

A unified Height & Containment Volume with a geofence — and, critically, demonstrated deceleration behaviour at the boundary so the aircraft is shown to stop, not merely told to.
geofence-proximity flights showing deceleration within the SCV
04

Flight termination system

The last layer: an independently activated FTS with dual-system redundancy, assured to function even if the layers above it have all been exhausted.
independent activation and redundancy proven in test
heliguy pilot and Network Rail observer watching a Matrice fly over the demonstration site
the evidence, in the air

Thirteen flights that turned argument into assurance.

Geofence-proximity runs, deceleration trials, strobe-visibility comparisons and trigger-distance confirmation — the boundary behaviour the CAA needed to see, flown and recorded over live infrastructure.

DJI Dock 3 · M4TD · Romford & Gloucester · demonstration programme
the remote operations command centre

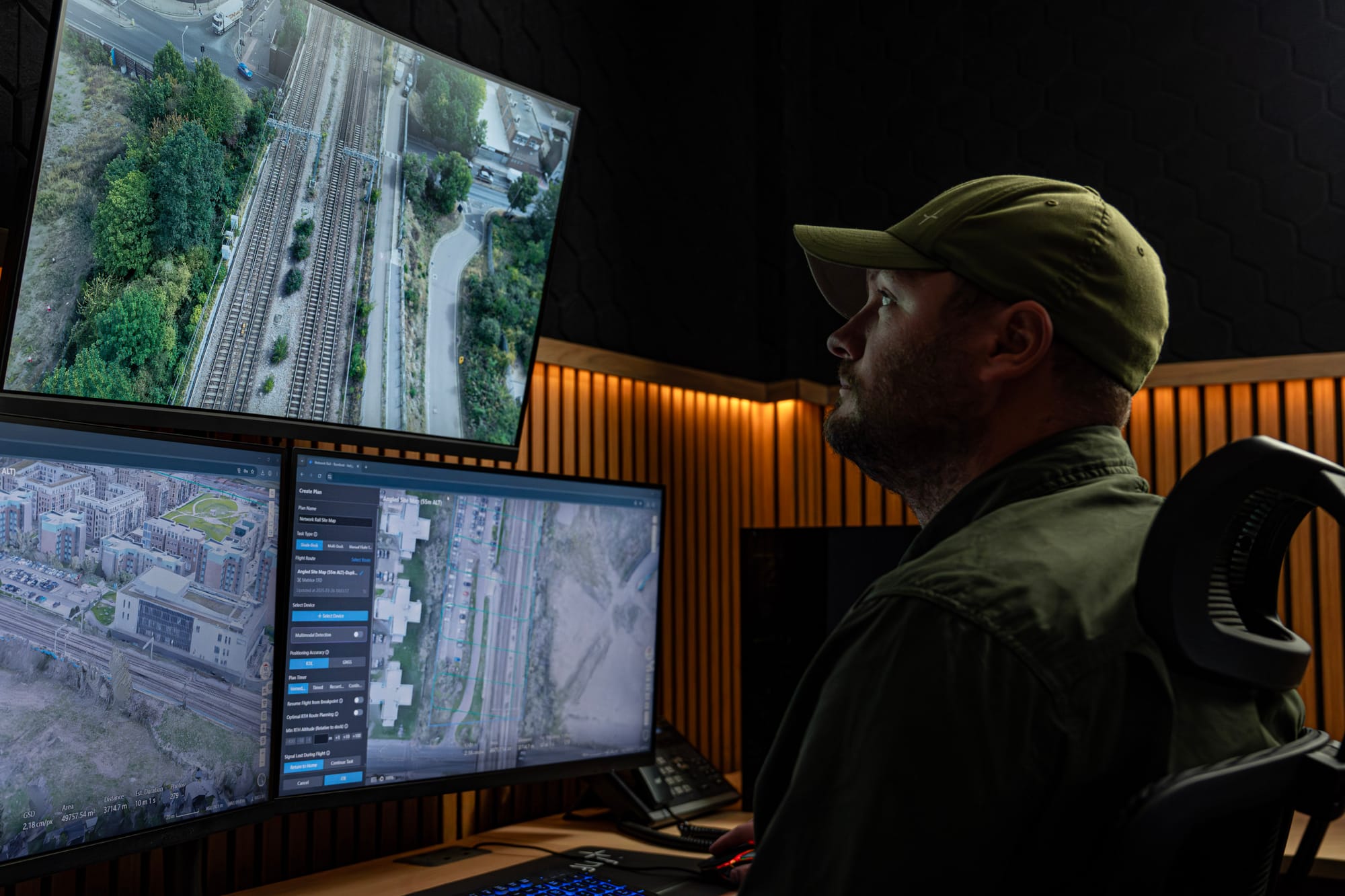

One command centre. Hundreds of sites.

Today the ROCC in Newcastle upon Tyne commands flights over live rail in Romford and Gloucestershire — 200-plus miles away, no one stood beside the aircraft. That’s the model, and it’s built to scale: every new site is another node on the map, not another team on the road. The plan is a national network of sites, all flown from one place.

Newcastle upon Tyne · ROCCRomford · ≈250 miGloucestershire · ≈200 miScaling to hundreds of sites
Gloucestershireoperation site≈ 200 miRomfordoperation site≈ 250 miNewcastle upon TyneROCC · command centre
05 · the findings dialogue, decoded

What the CAA asked — and what it really meant.

An approval is a conversation. The CAA raises findings; you answer them with evidence. These are the themes that shaped ours, written as pattern-level guidance — the questions anyone pursuing SAIL II should expect.

What it really means

Prove crewed aircraft genuinely won’t be where you’re flying — not just that they’re unlikely to be. The whole air-risk argument rests on this.

What we submitted

The iterated AAE methodology through to Option 5, with the enhanced buffer derived from infrastructure safety requirements after CAA internal review.

What it really means

A geofence on a slide isn’t assurance. Show the aircraft physically respects the boundary under real conditions.

What we submitted

The layered containment model plus demonstrated deceleration within the containment volume across dedicated proximity flights.

What it really means

Justify the buffer between where the aircraft normally flies and where it could end up before termination — with method, not guesswork.

What we submitted

A derived contingency-volume methodology tied to the aircraft’s demonstrated behaviour, with the shape of the calculation published and the figures held for sign-off.

What it really means

Command-and-control is the lifeline. Show what happens when it degrades or drops entirely.

What we submitted

Link-robustness evidence paired with the predictable-behaviour and fail-safe layers, so a C2 loss resolves to a known, safe outcome.

What it really means

A fail-safe that shares a failure mode with the thing it protects isn’t a fail-safe. Prove independence.

What we submitted

The independently activated FTS with dual-system redundancy, assured to function when every prior layer is exhausted.

What it really means

Operating near a control zone means the approval isn’t yours alone — ATC and other airspace users have to be accounted for.

What we submitted

ATC liaison for the London City CTR proximity, plus stakeholder engagement with HEMS, NPAS and MAMC-LF, and an electronic-conspicuity solution.

06 · a genuine industry first

Electronic conspicuity, on a DJI airframe.

Ping2020iADS-B OUT · 1090 MHz24-BIT ICAO ADDRESS40 4B ▓▓
industry first

Buried in the evidence pack is a genuine first: a uAvionix Ping2020i transceiver fitted to a DJI aircraft, broadcasting its position with a 24-bit ICAO address — developed in conjunction with DJI.

It makes the aircraft electronically conspicuous to other airspace users and ATC — the difference between asserting separation and letting everyone else see exactly where the drone is.

Ping2020i
uAvionix transceiver
24-bit
ICAO address
ADS-B
out · 1090 MHz
07 · the evidence culture

The CAA approves evidence, not adjectives.

Every claim in the submission traces to something that was measured, flown or tested. That’s the difference between a safety case and a brochure.

01

HIAL strobe testing

A 60 fpm upward-facing strobe assessed through comparative visibility trials — conspicuity proven by observation, not specification sheet.

02

Thirteen demonstration flights

A documented flight programme over live infrastructure, each sortie evidencing a specific element of the containment and conspicuity argument.

03

Deceleration-within-SCV trials

Dedicated runs proving the aircraft decelerates and holds inside the standard containment volume at the geofence boundary.

04

AirSense trigger-distance

Trigger-distance confirmation from DJI for the onboard AirSense traffic awareness — the detection envelope quantified, not assumed.

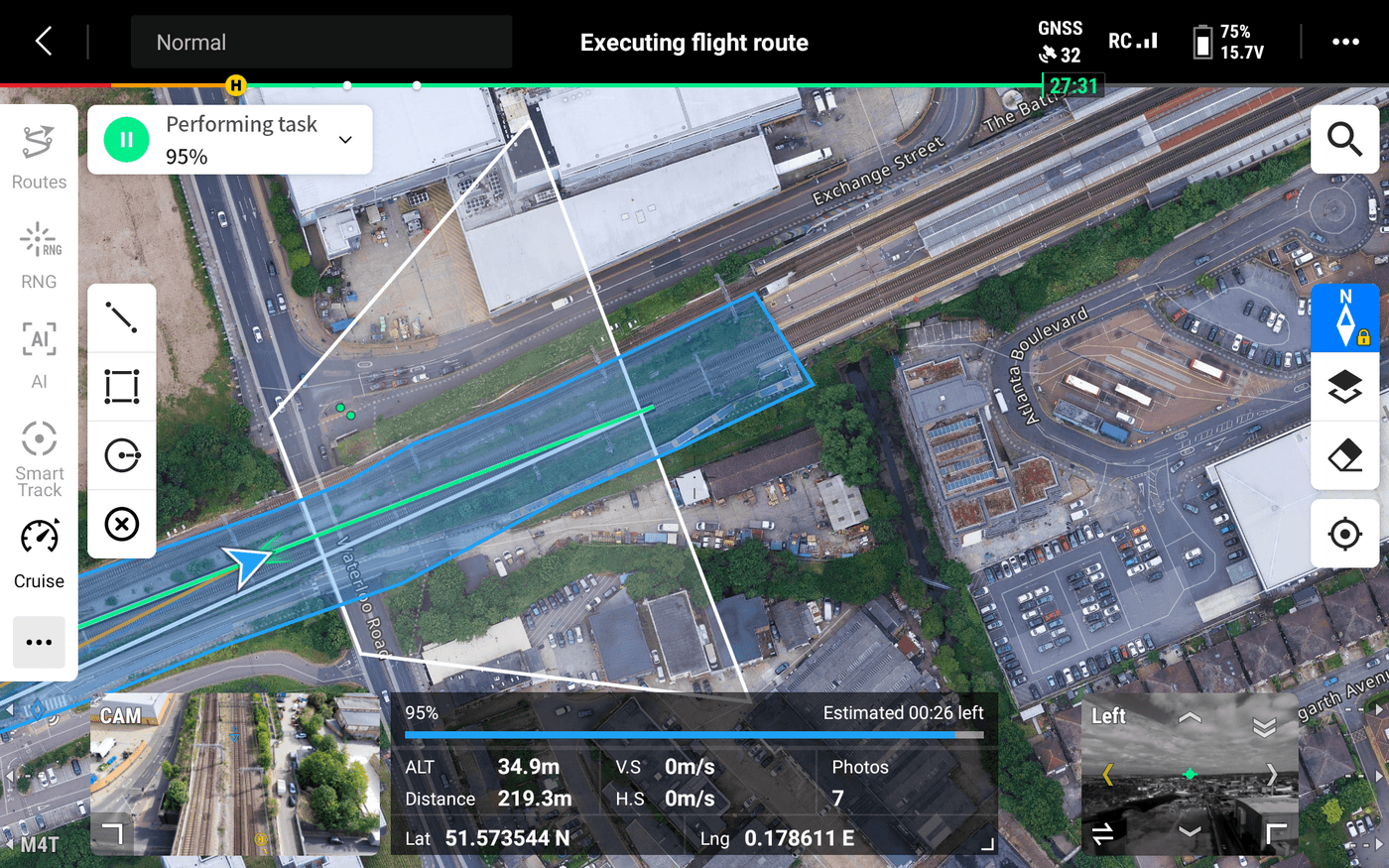

FlightHub 2 executing an automated flight route over the rail corridor
Automated route execution
FlightHub 2 · M4TD · GNSS 32

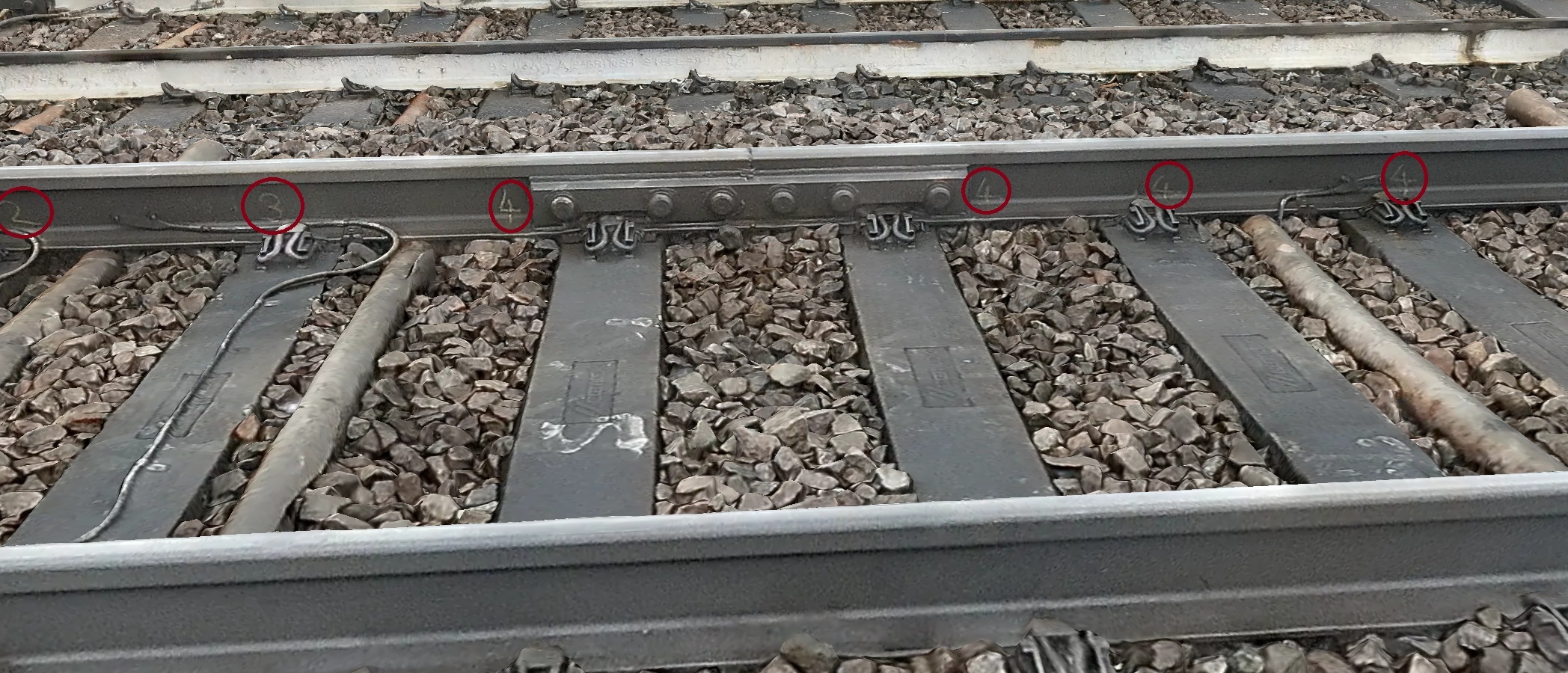

Close inspection imagery of rail bonding captured by the aircraft
Inspection-grade capture
Bond & fixing detail · over live track
heliguy and Network Rail reviewing data trackside
Reviewed trackside, together
heliguy · Network Rail · on site
08 · the partnership dimension

Approvals enterprise asset owners co-author.

The hardest part of the air-risk case — the enhanced buffer in Option 5 — didn’t come from a textbook. It was derived from Network Rail’s own infrastructure safety requirements, folded into the methodology after CAA internal review.

Network Rail provided a supporting statement on operations over live track and the framework for minimum-height clearance. That’s not a vendor relationship — it’s an asset owner co-authoring the approval that lets its own infrastructure be inspected from the air.

For any infrastructure operator, that’s the model: the people who own the risk help shape the case that manages it.

Option 5
enhanced buffer derived from Network Rail infrastructure safety requirements
65 ft
minimum-height clearance framework over live track
Live track
supporting statement on operations over an active railway
heliguy and Network Rail teams together at the demonstration site above live tracks
heliguy & Network Rail teams on site, above live tracks
from enquiry to first flight

How a site goes live.

Adding a site is a repeatable process, not a bespoke project. Once the first is running, each new location follows the same path — which is how the network scales to hundreds.

01

Survey

We assess the site, the missions you need flown and the airspace around it, then scope the operation.

week 1
02

Install

DJI Dock 3 sited, powered and connected; aircraft and payload commissioned on location.

weeks 2–4
03

Approve

The site’s BVLOS case is added under our operational authorisation — written and held by us.

in parallel
04

Fly to schedule

Our BVLOS pilots operate the site from the ROCC on the cadence you set; data flows to your teams.

ongoing
the commercial model

Per site. Priced to your schedule.

A hybrid model: a per-site service fee covers the dock, approval and standing readiness, and a usage element scales with how often you fly. Predictable, per-site, and it grows only as your network does.

Per-site service feeUsage by scheduleNo capital hardware outlayScales site by site
the conversion engine · gated asset

The Managed BVLOS Buyer’s Guide.

What a fly-for-you site programme actually involves — what heliguy handles, what you provide, how sites operate under our authorisation, and how the per-site model is priced. For anyone weighing BVLOS as a service against building it in-house.

We’ll email the guide and occasional BVLOS updates. No sharing, unsubscribe anytime.

start the conversation

Scope your sites.

Tell us how many sites, where they are and what you need flown. We’ll come back with a per-site plan, an installation path, and how they’d run under our authorisation.

We’ll use your details only to respond to this enquiry.

where you go from here

One partner, site to schedule.

managed service

Put your sites on the network

Tell us where your sites are and what you need flown. We install, approve, operate and maintain — flown by our BVLOS pilots under our authorisation, to a schedule you set.

Scope your sites
the platform

See what flies your sites

DJI Dock 3 and the Matrice 4TD, run through heliguy — the drone-in-a-box that carried this approval over live rail and now scales across the network.

Explore Dock 3 & M4TD
status openstation ne29 7se54.9914°n · 1.4378°w
